Dirk Depoorter

Friday, February 6
It's been a year since we were in Gambia. In 2025, we were able to achieve a lot with Gammol again, thanks to all our loyal sponsors and Omar and Lamin on site!
We traveled with a clear agenda:
- Monitoring the (now 5) Gammol schools. The goal was to make progress with the "Gammol School Committee" (GSC). Each school was informed of our visit, so they could prepare.
- Making two large water installations installed by the EU 30 years ago fully operational again.
- Setting the other priorities for 2026.
- And, as every year, almost obligatory, visiting a number of new installations.
We landed at 7:20 PM, after a short stopover in Dakar. We were happy to see Lamin and Omar again, who picked us up and took us to the "Mama Africa" lodge.
Ensa Sanyang - Gammol School Committe
That same evening, we had our first meeting with Ensa Sanyang, the man we'd like to appoint as coordinator for our school committee (GSC). This committee's primary goal is to improve the quality of instruction in our Gammol schools. It serves as a learning platform where the different schools can learn from each other.
Ensa provided us with an update, which revealed that the Sanchaba school still lacked the necessary motivation to actively participate in the GSC. This initial meeting also revealed that the priorities for our schools are finding and paying good teachers, providing sufficient materials, and organizing exams. In the long term, Ensa considers the benefits of a shared portal, as well as greater coordination in student monitoring.
It became clear to us that a great deal of work remains to be done to make progress with the GSC.
Saterday, February 7
Faala Village

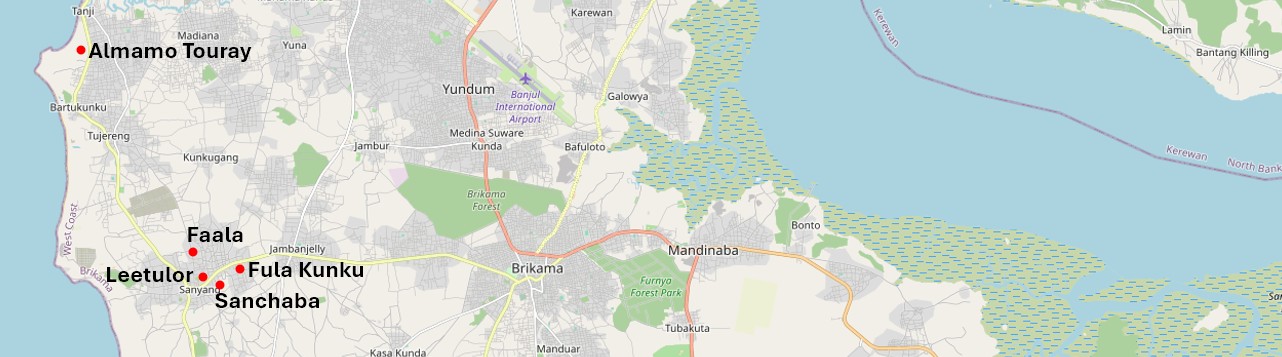

Faala Village is the first school we visit. We meet with Sainabu Jawla and Ousman Bojang (GSC leaders), Muhammed Faye (head teacher), Malang Bojang (village chief), and Isabou Jannel (English teacher). The goal is to understand their most important needs, how they view their role at the GSC, and whether there has been any progress in education.
It quickly becomes clear that the biggest problem is finding and paying good teachers. The children's parents contribute, but this isn't always enough to pay for a good teacher. The monthly cost: 8,000 to 10,000 Dalasi, or between €95 and €115. Something we'll hear in practically every school…
We also notice the enthusiasm, both from the children who welcome us and the teachers who make the most of the resources they have.
Other priorities: an extra toilet, finishing the kitchen so the children can have a meal, learning materials, more classes (they currently have to merge two classes because there are too many students wanting to come to the Gammol school), and a teacher's room.
At each school, we also explain in detail the purpose of the GSC and the responsibility we will place on it. We want the GSC to determine priorities across the five schools. This forces them to look beyond their own school. Based on these priorities, which the GSC will determine, a budget will be allocated. This will be a significant stretch for the five people who will represent their schools in the GSC. And this also entails a significant responsibility.
Gammol headquarters
We pass by our Gammol House to see the renovations Omar has done to make it more pleasant for the students who stay there every year. There's now a walled terrace that ensures privacy. A success. What still needs to be done is clearing out the garage, which is full of clutter.
Sanchaba School

Meeting at the Sanchaba school with Lamin Bojang (GSC representative), Saikou Tijan Bojang (internal affairs officer), Yankue Saidy (head teacher), and Fatoumata Jallow (English teacher).
Like Faala, this is an Arabic school. Our other schools are English schools. The difference is the amount of English the students receive. Our long-term goal is to have the same tests in all our schools so the GSC can monitor this. We certainly haven't reached that level yet.
We discuss the role of Amanah, the Gambian umbrella organization for Islamic schools. It's important for us to know that education here offers the same opportunities for children to continue their studies later in life.
179 students, 5 teachers, 2 of whom teach English, but only 1 is officially qualified. The first priority and greatest need: teachers. Motivated teachers! And Dalasi to pay them better. Because now they're losing their best teachers to private schools. In addition, there's also funding to feed the children in the afternoon. This is the second school we're visiting, but it's enough to get a sense of the needs. We suspect this will also be the case at the other three schools.
Here too, we explain the GSC's objectives. And again, we realize this isn't straightforward. Explanations are given from various perspectives, and Omar also translates them into Mandinka or Wolof (local languages).
Wait and see... Ensa gives us the impression he's "got it" and seems well-placed to play a role. We're clearly not yet at the level we want with the GSC. We realize it won't be easy, and ideally, someone will coordinate this. And then budget for it as well.
Sanyang Village
Meeting with the Village Development Committee: Botto Gaye (chair), Yusupha Jassey (secretary), and the VDC members.
This visit specifically focuses on the problems in their (very large) community garden. After some small talk and a thank you for the extra taps we installed at their fish market on the coast, we get to the heart of the matter. A large number of the reservoirs in the community garden are no longer being filled with water due to a faulty system. On June 10, 2025, we sent them an M.o.U. (memorandum of understanding) to be signed by the VDC and the Alkalo (village head). For each installation or building, we draw up a similar contract outlining the obligations of all parties involved. Eight months later, the Alkalo still hasn't signed it. A full explanation is given, while the essence is that the VDC and the Alkalo are abandoning the population (especially their women). They promised us that everything would be signed the next day!? It later turned out that wasn't the case.
Sanyang Garden
We go on-site to assess the situation and see that the reservoirs in the front of the garden are indeed still not receiving water. The result: women and children are back to hauling impure water up from wells in buckets, using the old-fashioned method. It's sad and appalling to witness, but after all these years, we've learned that we have to stand our ground if we want to change the mentality of some of these men.
Rice project

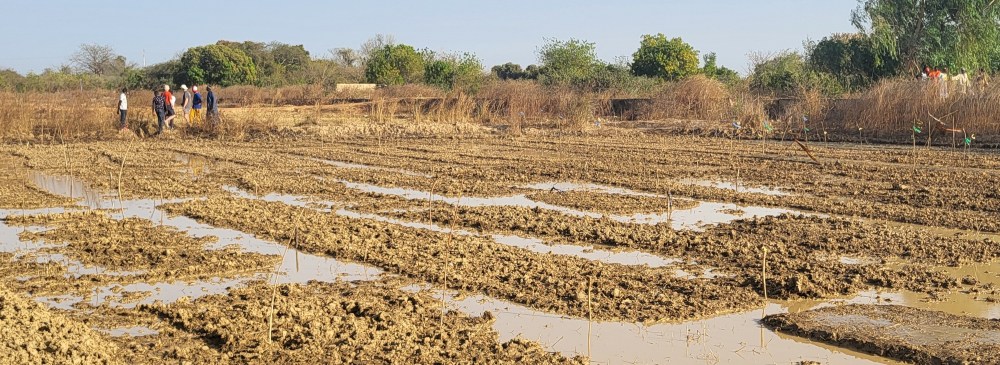

In the evening, a meeting with Almamo Touray, the person responsible for the rice project we launched last year. It wasn't an easy meeting. We had to conclude that continuing the project based on the current situation isn't feasible. The stumbling block is developing the land for rice paddies. These old rice paddies are now forested and need to be cleared. There's also the need for equipment (tractors, plows, water pumps, irrigation canals, etc.). Moreover, the government is interfering, making the entire project unaffordable for us. At most, there are 10 to 15 hectares left where the costs are manageable. And even that's too small to make it a worthwhile project.
We're currently somewhat stuck with this project. The first pilot project we set up only cost us a few thousand euros, and the second broke even, but we don't want to take risks that could impact our other projects. We ask Almamo to further develop the business case based on all the data currently available, and then decide what we will do with it.
Sunday, February 8
Kuluro Nema

One of the many new projects completed in 2025. A village of over 3,000 inhabitants, which will expand to over 5,000 in the coming years. The exact number is always difficult to determine. It depends on the number of residents per compound. So, a rough estimate. We are welcomed by Edrisa Saidy (brother of the Alkalo), Abdoulle Bojang (VDC chairman), Omar Bojang (village elder), Momobou Bampha (responsible for the water tower), and Isa Fanta Seyai (women's representative).
After the usual words of thanks—"First time we have pure water in our village, water is life, happiest people in The Gambia, we are going to pray for Gammol, God bless you..."—the questions follow: repairing a leaking school roof, toilets for the school, food for the children at the school, extensions for communities next to Kuluro. With this last point, they demonstrate their desire to show solidarity with other villages. They are also willing to invest, if resources are available, in additional water supply in their village.
Regarding the school: an English school with 300 students and six teachers who are underpaid, absent in some months due to a lack of funding. The parents contribute what they can, but their contributions are far from sufficient.
Dirk thanks them for their hospitality and explains how Gammol operates. He emphasizes that we can and want to be partners, but that this depends on them. The extent to which the village itself takes initiatives, takes action, and invests in development, such as creating a community garden and building a marketplace, which will provide them with resources (read: Dalasi), partly determines what Gammol does.

Kuluro Tunjina Garden
We visit the community garden, where we discover a problem with the controller. It turns out to be broken, and repair costs 162,000 D, or approximately €2,000. This isn't a Gammol system. We say we want to look into it, without any promises. If we want to maintain this with Gammol, a Memorandum of Understanding (M.o.U) with clear agreements must first be in place.
Faraba Kariaba

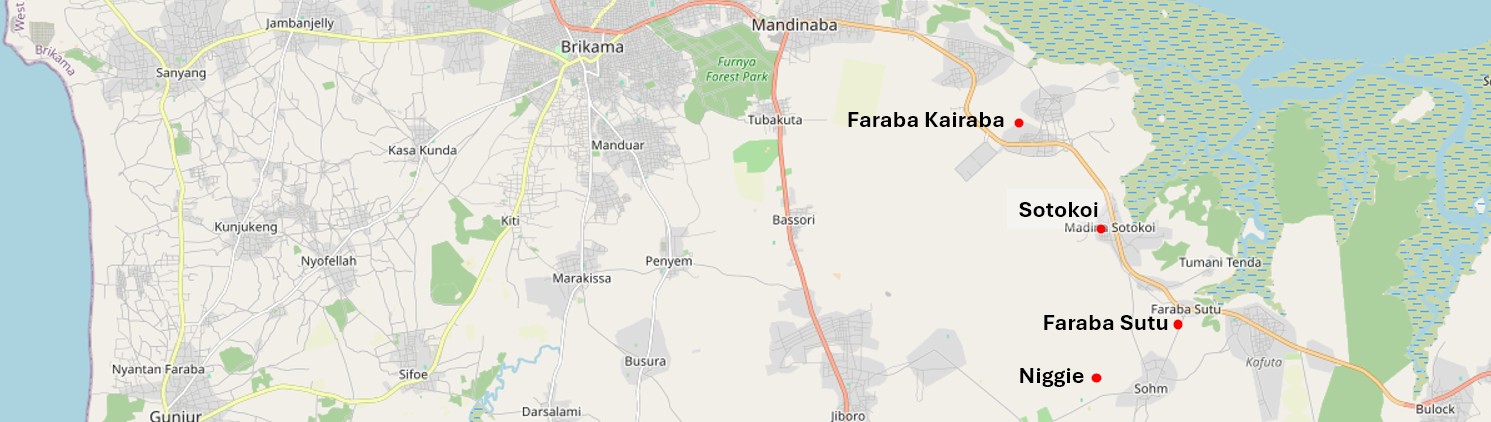

We are welcomed by a large delegation of about 25 people. This village is home to one of the two EU projects we visited last year, which is no longer functioning properly. We're considering taking it over with Gammol to guarantee its continued operation. A water system, installed in 1995, with an 80,000-liter tank, metered taps connected to 91 compounds, and 76 street taps have been disconnected. The reason: the system no longer runs on solar energy, the panels are defective, but on electricity. As a result, only compounds that can afford the electricity still have clean water.
In total, there are more than 300 compounds in Faraba. In the surrounding area, there are even 2,000! The electricity cost is 260,000 D per year (approximately €3,100). They urgently request assistance to repair the system. Costs approximately D800,000 (€9,600): control box D175,000, pump D400,000, and 20 to 25 solar panels D200,000. This is the price of one of our standard installations, except that the water tank here is eight times larger than ours.
We want to discuss this with a small group, a maximum of five people. It takes some effort to make it clear to the twenty others that they are no longer welcome to discuss this. Our reason: we know that otherwise everyone will want to share their opinion, which would waste a lot of time. We agree to carry out the repairs and place the water installation under the care of Gammol. In exchange, they will pay Gammol D130,000 (half of the annual electricity bill) for four years. This is Dalasi that we can use for other projects in Gambia. It takes some time and explanation to convince them, but they ultimately agree. Once back home, a Memorandum of Understanding (M.o.U.) needs to be drawn up, clearly documenting all agreements. Just like we do with our other projects.
Tumani Tenda
We are welcomed by Emoula Manga, head of the VDC. A village with about 50 compounds, each with a water system on Emoula's private land, but with the promise that the entire village can benefit from it. Each compound has a tap, for which they pay a monthly fee of 10 D (12 centimes). Their water system is a tanker truck container, I estimate about 25,000 liters, which they've placed on concrete poles. Creative. How they did it is a mystery to us. According to them, the problem here is that the pump isn't powerful enough, because the outermost compounds aren't getting water. And the water tastes of iron because the drilling was done too deep.
Here too, they're asking for our help to drill a new, shallower well and install a new pump. However, we're not sure whether that's the solution to their problem. First and foremost, they need to regularly clean their panels, which are covered in dust. In addition, the water quality must be tested before and after it enters the container. Perhaps the container is contaminating the water? Finally, they must test whether the furthest compounds receive water once the tank is filled. There's a persistent belief (and not just here) that a more powerful pump will provide the compounds (or public taps) with sufficient water. However, it's the height of the tank that creates the pressure to distribute the water. Therefore, it must first be determined whether the water tank fills and whether the pipes are suitable.
Once this is clarified, we are willing to help them and turn it into a Gammol project as well.

Kafuta Village
One of the new projects, completed in 2025. We are welcomed by Lamin Jadama (area chairman), Musa Kanteh (borehole manager), Lamin Bojang (Alkalo), Sheriffo Camara (village elder), Ebou Jobe (VDC chairman), Bintah Bah (regional councilor), and Nyima Kanteh (Woman's representative), along with a large group of villagers. This, despite them saying that this is only a limited group, as a circumcision ceremony is taking place.
The usual words of thanks are given, along with the equally usual request for more water. We then give our usual speech, emphasizing that additional interventions will only be considered if the village can demonstrate that they are also taking action to make progress.
